Main content

Waitsfield Community Wastewater Project

Why: Goals of the project

  • Protect water quality in the Mad River
  • Safeguard human health near water wells
  • Ease economic burdens of septic system replacements
  • Expand housing options and boost economic activity
  • Preserve historic settlement patterns
  • Build and maintain a modern wastewater system with affordable user rates and no impact to the municipal tax rate

What: Components of the Wastewater System

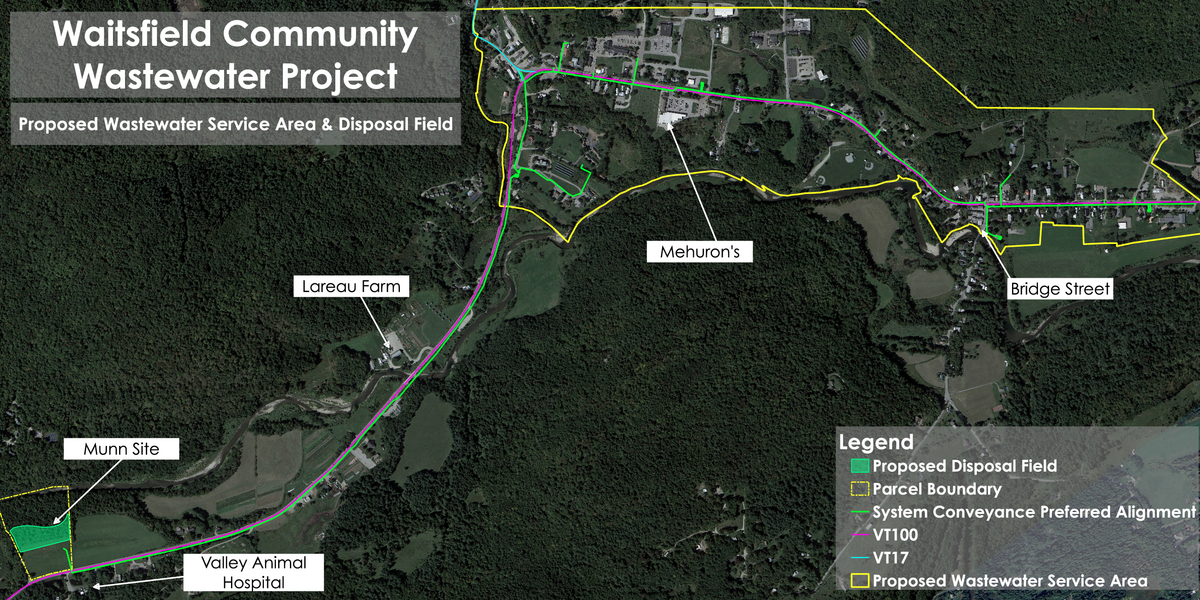

A municipal wastewater collectiontreatment, and disposal system. Estimated cost: ~ $18.5 million.

  • Wastewater Collection
    • Serving Irasville & Waitsfield Village
  • Treatment & Disposal
    • Multi-stage treatment and in-ground disposal of 89k gallons per day at the town-owned Munn Site

How: Construction & Operation

Federal and state grants are being pursued as the primary funding sources, supplemented with federal and state loans to be repaid through affordable user rates and future Local Options Tax revenue. The system's construction and operation are designed not to impact the Waitsfield municipal tax rate.

Planning and design have been ongoing since 2021 and moved into the Final Design phase in January 2024.

The project design is expected to be completed, including final permitting approvals, by June 2026. Before finalizing the design, additional topographic surveys and underground utility verifications will be conducted throughout spring 2026.

The wastewater treatment facility and disposal system at the Town-owned Munn Site will require clearing ~2.5 acres of trees. Tree clearing at this site is scheduled to occur before April 15, 2026, to meet funding and environmental requirements. Procurement is underway, and Town staff are in the process of notifying nearby property owners.

The project is expected to enter the Bid Phase in summer 2026, with construction anticipated to begin in fall 2026.

Responsive Embedded YouTube Video

Key Milestones

Bond Vote Success

On 6/11/24, the voters of the Town of Waitsfield passed a bond vote for the Community Wastewater Project by a margin of 3:1 (415 yes to 140 no). This served as a major project milestone, permitting the pursuit of federal and state funding to proceed with the project.

Final Design Phase Progress

Building on the progress made through summer 2024, the Waitsfield Community Wastewater Project has continued advancing through the final design phase, with ongoing work on design development, property owner coordination, permitting, and securing funding. The overall project approach remains the same: a wastewater collection system serving Irasville and Waitsfield Village, paired with a multi-stage treatment facility and in-ground disposal of approximately 89,000 GPD at the Town-owned Munn site. In August 2024, the Town and DuBois & King executed Amendment #3 to the Engineering Services Agreement, formally advancing the project through final design, including engineering, permitting, cost estimating, and the preparation of construction documents.

DuBois & King submitted the 90% design (D90) to the Town of Waitsfield on March 31, 2026, covering both the wastewater treatment facility (Contract No. 1) and the collection system (Contract No. 2). After review by the Waitsfield Community Wastewater Project Team, the D90 package will be shared with VT Agency of Transportation, VT Agency of Natural Resources, the VT Division for Historic Preservation, and project funders, with permitting approvals expected as part of that process. Final design completion, including all permitting, is targeted for June 2026.

Additional Topographic Surveying

Although most topographic survey work was completed in 2024, additional surveying is scheduled for early April 2026 to support recent design updates, including realigning the conveyance pipe along Slow Road rather than VT 100 and adding more service connections. Town staff is currently notifying landowners.

Underground Utility Location Work

In early April 2026, DuBois & King will conduct subsurface utility locating at proposed pump station sites (Fiddler’s Green, Upper Irasville, Bridge Street, and Waitsfield School) to verify existing conditions and identify any potential conflicts with the final design. Town staff is in the process of notifying landowners in advance.

Tree List

Additionally, DuBois & King have created an updated inventory of trees that could be affected by construction, including those along the main conveyance route and individual service connections. This list was reviewed in collaboration with representatives from the Waitsfield Tree Board to identify significant trees for potential avoidance. Design adjustments are being considered to reduce impacts where possible. Many ash trees were not prioritized for avoidance due to expected removal related to the Emerald Ash Borer.

Munn Site & Tree Clearing

The treatment facility and disposal system will be located on the Town-owned Munn Site at the intersection of Kingsbury Road and VT Route 100. The structure will be positioned at the back of the open field, with approximately 2.75 acres reserved for subsurface disposal. Developing this area involves clearing about 2.5 acres of trees. To meet funding requirements and protect sensitive wildlife habitat, tree clearing must occur before April 15. Procurement for this work is underway, and neighboring property owners will be notified.

Easements

The project will require permanent easements and user agreements for system connections, pump stations, and conveyance infrastructure. Town staff is collaborating with legal counsel to develop draft agreements for distribution to affected property owners through spring 2026.

Priority Parcel-Owner Outreach

Since mid-January 2026, approximately 70 site visits have been conducted with owners of priority parcels to share project updates, collect field data for final design, and discuss planned connections.

Funding Updates

The Waitsfield Community Wastewater Project has obtained substantial funding to support both design and early construction stages. The Vermont Department of Environmental Conservation’s Clean Water State Revolving Fund (CWSRF) and the American Rescue Plan Act (ARPA) have covered all engineering and final design expenses and are anticipated to fund the initial construction phase.

ARPA & VWWW Funding

In mid-September 2024, the Vermont Department of Environmental Conservation (VT DEC) informed the Town of Waitsfield that it had received $2,508,085 in State American Rescue Plan Act (ARPA) Village Water & Wastewater (VWWW) Initiative funding. Later, in April 2025, Waitsfield was notified that it had been chosen to receive an additional $1,000,000 from this program. The town’s selection for these awards partly depends on the project’s position on the State of Vermont's Clean Water State Revolving Fund (SRF) 2025 Project Priority List (PPL). This funding will cover all final design activities for the project through bid-ready contract documents (ESA Amendment #3), with the rest allocated for construction. All ARPA VWWW funds must be spent by 9/30/27.

CWSRF

Due to the Town’s high ranking on Vermont’s FFY25/SFY26 CWSRF Intended Use Plan (IUP), the project qualifies for CWSRF construction financing. This includes eligibility for a 50% subsidy and up to $1 million in loan principal forgiveness, with a deadline of June 30, 2026. The IUP covers key program details, such as Project Priority Lists (PPL), subsidies, loan forgiveness, and loan terms. To stay eligible for funding, the Town submitted a new Project Priority List application to VT DEC on February 6, 2026, for the FFY26/SFY27 funding cycle; results are expected in the next IUP draft, anticipated this summer.

Additional Funding Efforts

Additional funding efforts have been successful across multiple programs. The Northern Border Regional Commission (NBRC) Catalyst Program awarded the Town $1 million in fall 2025 to support connections to Waitsfield School; the project is currently undergoing NEPA review. The Town has also secured a USDA Rural Development package, consisting of a $649,000 grant and a $7.552 million loan.

The Town has submitted applications for FY27 Congressionally Directed Spending requests from Vermont’s three representatives—Rep. Balint, Sen. Welch, and Sen. Sanders—seeking EPA STAG Clean Water SRF funding to further support the construction of the project.

Wastewater Treatment Facility Emergency Response Plan

RCAP Solutions created an initial draft of the Emergency Response Plan (ERP) and Vulnerability Assessment for Waitsfield’s Wastewater Treatment Facility in late February 2026. This work is a requirement for the Town’s upcoming USDA Rural Development Loan for Waitsfield’s Community Wastewater Project. RCAP Solutions performed this work at no cost to the Town of Waitsfield, as it was part of RCAP’s contract for technical assistance related to disaster issues for community facilities.

Wastewater Ordinance

The Waitsfield Water Commission is in the process of developing a draft Wastewater Ordinance for future consideration by the Waitsfield Selectboard. Water Commission members have experience in this area, having drafted the Water Ordinance currently in place.

2026 Project Milestones

The following activities will be taking place in 2026 in support of final system design:

  • D90 review & feedback - March/April 2026
  • Additional topographic surveying - March/April 2026
  • Underground utility location work - April 2026
  • Munn Site tree clearing - will occur prior to April 15
  • State regulator & funder review of D90 - April 2026
  • Final Design - June 2026
  • Wastewater Ordinance discussions - Summer 2026
  • Bid Phase - Summer 2026
  • Construction - Fall 2026

To learn more about these next steps, visit the page linked below.

Questions or comments?

If you have questions or comments about the Waitsfield Wastewater Planning Project, please email JB Weir, Waitsfield Planning & Zoning Administrator and Wastewater Project Team member, at jb.weir@waitsfieldvt.gov or (802) 496-2218 ext. 4.
